Track milestones

All plans Project Member

Milestones are the dates that matter: a launch, a contract deadline, a phase gate. Each one is a title and a due date with a completion toggle, shown on the project’s Milestones tab and summarized on the project Overview.

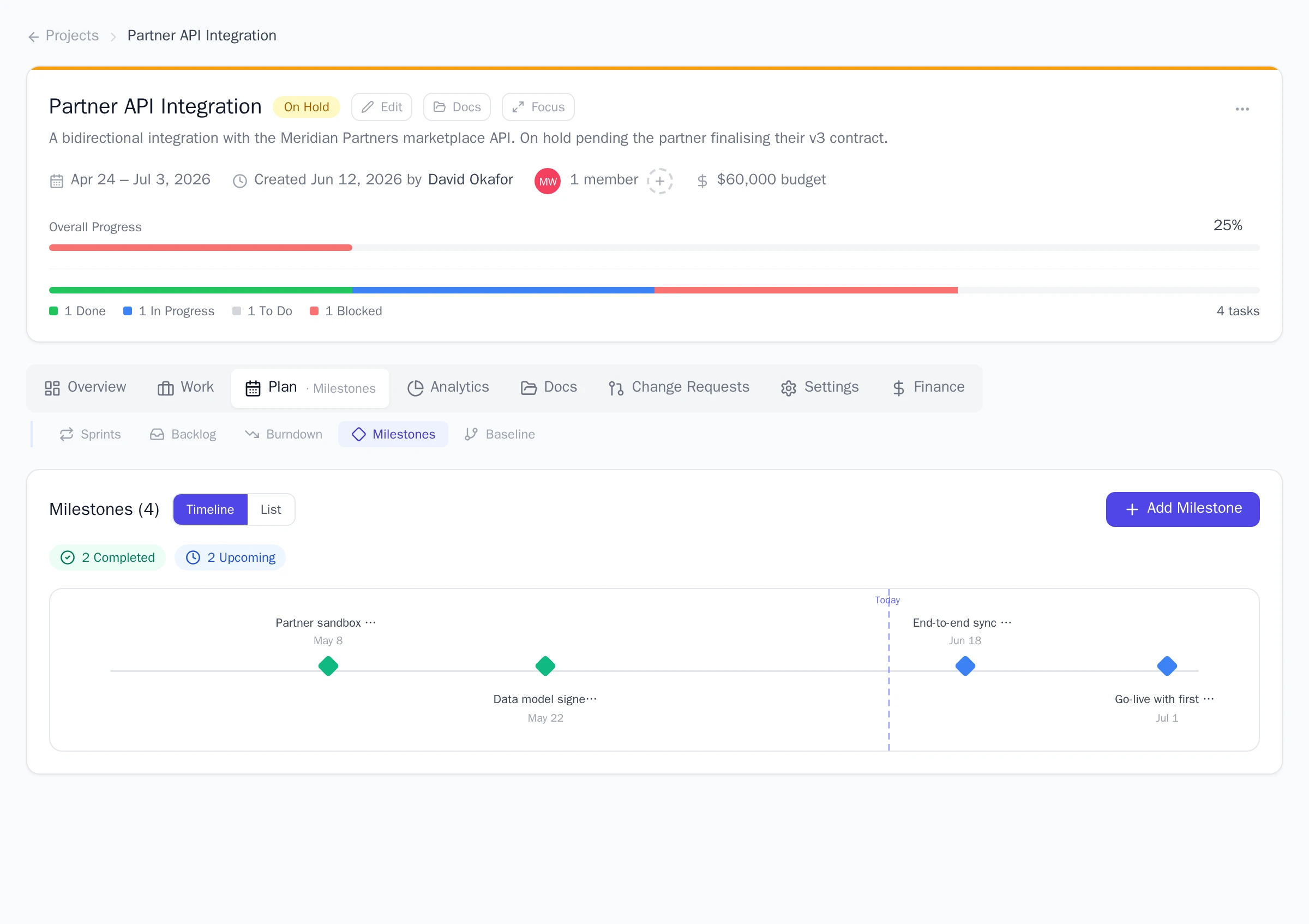

The Milestones tab in timeline view, showing four milestones as diamond markers along the project timeline with completed and upcoming status chips above.
  1. Open your project and select the Milestones tab.

  2. Select Add Milestone, enter a title and a due date, and select Add.

The tab has two views, switchable with the Timeline / List toggle:

  • Timeline lays the milestones out as diamonds along a horizontal line spanning the project, with a dashed Today marker showing where you stand. It is the default while the milestone count stays small; projects with many milestones default to List for readability.
  • List shows one row per milestone with its due date, a relative countdown (“in 12d”, “3d overdue”), and a status chip.

Click a milestone’s diamond to mark it complete; click again to reopen it. Color tells the story at a glance: completed milestones turn green, upcoming ones are blue, and anything past its due date and still open turns red. Chips above the views count Completed, Upcoming, and Overdue, and completed rows record the date they were finished.

In List view, hover a row for the pencil and trash icons to edit the title and date or delete the milestone.

Tasks have a Mark as milestone checkbox in the task form. A task marked this way renders on the Gantt tab as a diamond marker at its date instead of a duration bar, which is how key dates stand out on the timeline among regular task bars. This is also how milestones imported from Microsoft Project files arrive.

When a project has no milestone entries of its own, the Milestones tab automatically lists the project’s milestone-flagged tasks instead, labeled from task. These derived rows are read-only here: open the underlying task to change its title, date, or completion.

The project Overview tab includes a Milestones panel with the next few milestones and a View all link to the full tab, so the key dates stay visible without switching views. For the task side of the workflow, see working with tasks.

  1. Use milestones for the dates a stakeholder would care about, not every internal target. “Beta launch”, “Contract signed”, “Phase 1 hand-off” — yes. “Tuesday’s standup”, “code review” — no, those are tasks. A milestone-rich project ends up with 30 diamonds and no signal; a 5-7 milestone project tells a story.
  2. Anchor milestones to real external dates. Internal “we’d like this done by” dates are softer than “regulator demands by Sept 30”. The honest milestone reflects the date someone outside the team is measuring against, not the team’s wish.
  3. Mark milestones complete the moment they’re done, not at end-of-week. Live tracking is the entire value: the project Overview should reflect today’s state, not Friday’s snapshot.
  4. Use milestone-flagged tasks (not standalone entries) when the milestone has real work behind it. A “Beta launch” with assignees, comments, and a dependency graph belongs in the task model. A pure external date (“Contract signed by Acme”) works as a standalone milestone entry.
  5. Capture a baseline that includes your milestones. Variance against the baseline lets you say “Phase 1 hand-off was planned for Oct 15 and actually delivered Oct 22” — the single most useful stakeholder-update sentence you can have. See Capture and compare baselines.
  • My milestone-flagged task doesn’t show as a diamond on the Gantt. Two causes: (a) the task has no due date (the Gantt anchors it to the date); (b) the Gantt is filtered to exclude completed tasks and the milestone is completed.
  • The Milestones tab shows tasks I didn’t add as milestones. When a project has no standalone milestone entries, the tab automatically lists tasks flagged “Mark as milestone” instead. Add a standalone milestone and the auto-listing stops; or accept the derived rows (they’re read-only on this tab; edit the task to change).
  • A milestone marked complete went back to upcoming later. Someone toggled it. Onplana doesn’t prevent reopening — it’s intentional for cases where a milestone “completed” but evidence later showed it wasn’t. The activity log records the toggle.
  • My imported MS Project milestones are all dated the same day. MS Project sometimes stores milestone dates as constraints rather than scheduled dates. After import, verify the milestones’ due dates against the original plan; if any are wrong, edit them in Onplana (the source file isn’t touched).
  • The Overview panel shows milestones I don’t see on the tab. The Overview’s milestone panel shows the next few upcoming + any overdue; a milestone completed weeks ago is in the tab’s Completed view but not on the Overview by default.
  • Milestones + Gantt. Diamond markers on the timeline make key dates jump out among task bars. The critical path computation respects milestones the same as tasks. See Plan on the Gantt chart.
  • Milestones + Baseline. Baselines record milestone dates at capture time; variance reports show whether milestones drifted between then and now. See Capture and compare baselines.
  • Milestones + Status Reports. Status reports for stakeholders read most cleanly when organized milestone-by-milestone. The Status Report tab in the Reports area has a milestone-anchored layout. See Run cross-project reports.
  • Milestones + Notifications. A milestone going overdue can trigger a “Project status changes” notification (if your team has it enabled) — useful for catching slip without daily project reviews. See Manage notification preferences.
ToolMapping
Microsoft ProjectMilestone tasks (duration 0) ≈ Onplana milestone-flagged tasks; same diamond visual on Gantt
JiraNo native milestone concept; teams use issue type “Epic” or “Initiative” with a target date
AsanaAsana milestones are direct concept; same dual-track model (task vs lightweight marker)
SmartsheetDirect mapping
Monday.comDirect mapping

Why can’t I edit some milestones on the Milestones tab? Rows labeled from task are derived from tasks that have Mark as milestone ticked. Edit or complete the task itself and the row follows.

Do milestones affect task scheduling? No. A milestone entry is an independent date marker; it does not move tasks or create dependencies. Use task due dates and dependencies for scheduling, and milestones for the headline dates.

Who can manage milestones? By default, project members and above can add, edit, complete, and delete them. Project viewers see them read-only. Admins can adjust this in the organization’s permission matrix.

Can a milestone be assigned to someone? A standalone milestone entry doesn’t have an assignee — it’s a date marker. A milestone-flagged task does have an assignee like any other task. If the milestone has an owner, use the task model.

Do milestones count toward project progress? No. The progress rollup excludes milestones to avoid distorting the calculation. A project with 5 tasks and 5 milestones reads progress from the 5 tasks only.

Can I set a milestone’s date as a dependency target? Yes — a milestone-flagged task can be the predecessor or successor of dependencies like any other task. Standalone milestone entries can’t be dependency endpoints.

Are milestones shared across projects? No, milestones are per-project. For portfolio-level “key dates”, either use portfolio-level reports that aggregate per-project milestones, or use cross-project goals.
