Skip to content

Export a project to Microsoft Project

All plansAnyone who can see the project

Clients, main contractors and PMOs still work in Microsoft Project, and a schedule you cannot hand them is a schedule you cannot put in a contract. Any Onplana project downloads as an MS Project XML file that opens natively in Microsoft Project, on every plan including Free.

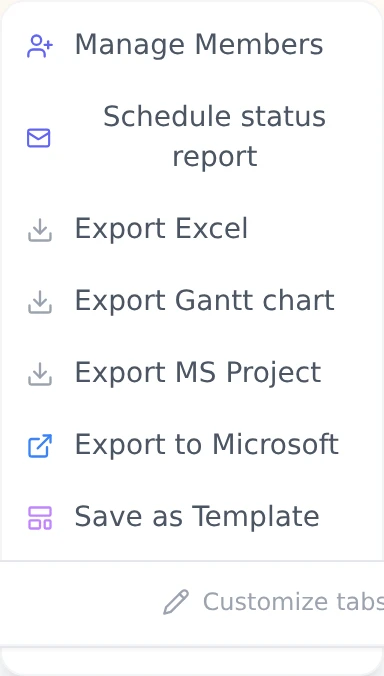

  1. In the project header, open the ⋯ menu.

  2. Choose Share or export, then Export MS Project in the list that opens beside it.

  3. The file downloads as <project name>.xml. Open it in Microsoft Project.

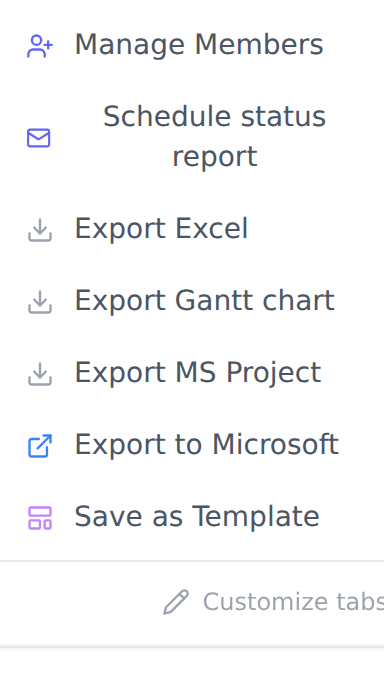

The Share or export list that opens beside the project header's overflow menu, listing Share a read-only link, Export Excel, Export Gantt chart, Export MS Project and Export to Microsoft.
How it arrives
WBS hierarchy Full depth. Parents stay parents, subtasks stay under them, in your order.
Dependencies Type and lag preserved. A finish-to-start link with 3 days lag arrives as one.
Milestones Flagged as milestones, not zero-length tasks.
Resources Matched to the people assigned in Onplana, with their assignments.
Progress Percent complete per task.
Costs Planned, fixed and baseline.
Notes From each task’s description.
Priorities Mapped onto the 0 to 1000 scale Microsoft Project uses.
Custom fields In Microsoft Project’s own field slots (Text1, Number1, Date1, Flag1 and so on), under their Onplana names, with every task’s value. A choice list keeps its choices.
Effect
Working calendar Microsoft Project applies its own default: Monday to Friday, no holidays.
Task constraints “Start no earlier than” and similar are not carried.
Deadlines Not carried.
Multi-select fields Not carried: a Project file has no slot that holds one. Nor is a field past the last slot of its type (30 text, 20 number, 10 date, 20 yes or no).
You want Use
A file for Microsoft Project Export MS Project
A spreadsheet of the task list Export Excel
The plan inside Planner or To Do Export to Microsoft

All three sit under Share or export in the ⋯ menu, on every plan.

Message What to do
More than 20,000 tasks The conversion runs in one request. Export a phase or sub-project instead.
Export service unavailable The converter is a separate service and was briefly down. Try again in a minute.
Anything else Ours, not yours. Report it with the flag icon in the header so we can see which project.
